A belt-type discharge semi-trailer is worth evaluating when a project must move large volumes of bulk material repeatedly but cannot rely on raising a conventional dump body at every unloading point. For Vietnam construction logistics, the relevant question is not whether a conveyor-based trailer is more advanced. It is whether the material, route, unloading surface, operating cycle and local approval path justify its higher equipment cost.
This is a project-led purchasing question. Port expansion, roadworks, embankments, industrial parks and material yards can create demanding flows of sand, aggregate, soil or similar bulk cargo. They are useful opportunities to investigate, but they do not automatically define the right vehicle or prove a purchase requirement. Before choosing a semi-trailer, the project team needs to understand how material arrives, how it is unloaded, how often the cycle repeats and which responsibilities remain with the contractor, carrier, dealer and local authorities.
Why Project Conditions Create a Different Vehicle Requirement

On a stable, repeatable construction haul, the daily bottleneck may be unloading rather than loading. A conventional rear or side tipper normally relies on a hydraulic lifting action. That can be practical when the unloading area is level, there is adequate clearance and the operating team has a well-controlled procedure. But those conditions cannot be assumed across every material yard, road embankment, port-access area or reclamation-related work zone.
A belt-type discharge semi-trailer uses a conveyor-belt unloading concept instead of relying solely on lifting the cargo body. The purchase case is therefore not simply “more volume.” It is the ability to assess a non-tipping unloading workflow for a specific material flow. The engineering and site teams should determine whether the discharge direction, discharge rate, floor condition, material characteristics, clean-out needs and operator procedure fit the actual job.
Vietnam’s construction and logistics activity makes this discussion commercially relevant, especially where large sites need a dependable bulk-material cycle. However, a project announcement, a port photo or a regional investment figure does not tell a buyer whether the site will use rigid dump trucks, standard tipper semi-trailers, local rental fleets or a conveyor-based semi-trailer. That choice must be confirmed through a real RFQ with the contractor and carrier.
Start With the Material Movement, Not the Trailer Name
“Conveyor belt dump trailer,” “belt-type discharge semi-trailer” and “tipper trailer” can lead buyers to very different vehicles. A productive first discussion describes the material movement in detail:
- Material: Is it sand, crushed stone, soil, wet aggregate or another bulk cargo? Moisture, particle size, stickiness and abrasiveness affect the discharge concept and wear points.
- Load per trip: What volume and legal working weight are required for the actual tractor-trailer combination, not only for a trailer catalogue?
- Unloading point: Is the ground firm and level? Is there room for the tractor to enter, position, discharge and leave safely?
- Cycle: Is this a one-off movement, a seasonal activity or a high-frequency project route that will run for months?
- Route: Which public-road, site-road, bridge, port-gate and turning constraints affect the combination?
- Operating responsibility: Who trains operators, inspects the system, handles routine maintenance and keeps spares available?
These answers should be gathered before price comparisons. They reveal whether a conventional tipper is the efficient baseline, whether a belt-discharge configuration deserves a technical review or whether the project should use a different transport method entirely.
What the Provided Configuration Comparison Shows—and What It Does Not

The supplied comparison sheet presents three relevant EXW reference configurations from a China-based source: a standard enlarged tipper semi-trailer, a box-type rear-dump semi-trailer and a belt-type discharge semi-trailer. The figures below are source-sheet reference data, not a quotation or an approved Vietnam specification.
| Reference configuration | Body volume | Listed load capacity | Listed tare weight | Listed EXW price |
|---|---|---|---|---|
| Standard enlarged tipper semi-trailer | 53 m³ | 55 t | 7.5 t | CNY 119,000 |
| Box-type rear-dump semi-trailer | 122 m³ | 70 t | 11 t | CNY 130,899 |

| Belt-type discharge semi-trailer | 85 m³ | 60 t | 12.5 t | CNY 266,680 |
On this source sheet, the belt-type reference has a higher EXW figure than either tipping reference. That is the important commercial starting point: the belt system should not be sold as the lowest purchase-price option. The buyer needs to decide whether a different unloading process, body layout and planned operating cycle can justify the added capital cost and maintenance scope.
Neither the listed 85 m³ body volume nor the listed 60 t load capacity is a usable operating promise for Vietnam. Final dimensions, gross combination weight, axle loading, road restrictions, structural calculations, cargo density, tractor selection, registration and site rules may all change the feasible configuration. A correct RFQ asks the supplier and local advisers to verify those variables before order confirmation.
How to Compare a Local Option With a China-Sourced Option
Local availability matters in any project. A local fabricator, dealer or fleet supplier may offer shorter response times, familiar documentation, existing workshop support or a configuration already used by nearby contractors. Those advantages should be evaluated honestly. At the same time, an imported China-sourced configuration may be worth comparing when the project needs a specific body layout, non-tipping unloading concept or a clearly defined set of equipment options that is not readily available through the local baseline.
The comparison should not end with an EXW number. A project team should build the same cost-and-risk checklist for every alternative:
- Vehicle configuration and material-contact areas for the actual cargo.
- EXW or local vehicle price, plus shipping, insurance, customs, taxes, inland delivery and commissioning.
- Tractor compatibility, axle arrangement, coupling and any modifications required for the combination.
- Destination-market approval, registration, inspection and operating-permit responsibilities.
- Expected belt, hydraulic, electrical and wear-part maintenance, including the local spare-parts plan.
- Operator training, safe unloading procedure and inspection routine.
- Downtime exposure: who diagnoses a fault, supplies parts and restores the trailer during a live project?
This is where a China-sourced solution can earn its place: not through an unsupported claim that every imported trailer is cheaper, but through a transparent configuration-and-delivery comparison. A supplier should be able to discuss the cargo body, unloading mechanism, operating boundaries, documentation needs and after-sales responsibilities in the same detail as the purchase price. If that comparison is not clear, the buyer has not yet reached a decision-ready quotation.

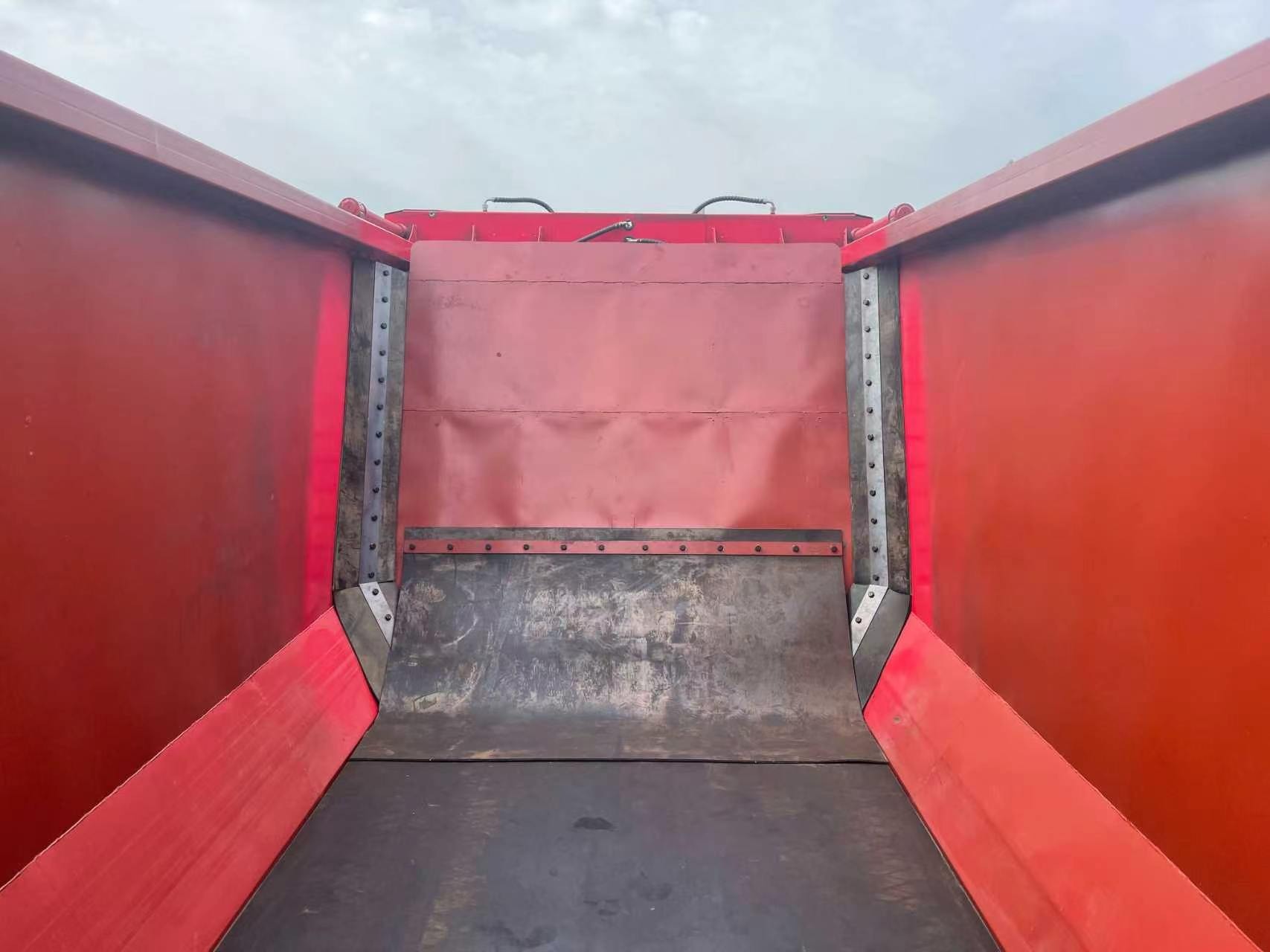

Why Non-Tipping Unloading May Matter on a Project Site
Conventional tipper operation requires a controlled lifting and unloading sequence. Large bodies, uneven surfaces, unsuitable material behaviour, restricted side clearance or weak site discipline can make that sequence harder to manage. A belt-discharge system changes the unloading method, but it does not eliminate operational responsibility. The site still needs an appropriate discharge area, defined exclusion zones, trained operators, inspection procedures and a plan for material buildup or obstruction.

The most useful question is therefore practical: what failure or delay does the project need to prevent? If the project has adequate tipping space, low cycle intensity and a limited budget, a conventional option may remain the sensible choice. If it runs a high-volume, repetitive route and needs to assess a controlled, non-tipping discharge workflow, the higher-cost belt configuration may justify a detailed comparison.
From Factory Configuration to Vietnam Jobsite: Questions to Settle Early
Export equipment becomes a project solution only when the factory configuration and jobsite reality meet. Before a buyer places an order, the technical and commercial teams should resolve the following:
- Which named material will be carried, at what moisture condition and bulk density?
- What are the maximum loaded dimensions and proposed axle loads for the complete combination?
- Which tractor will pull the trailer, and is its coupling and powertrain suitable for the route?
- Does the unloading area support the intended discharge process in all expected weather conditions?
- Which Vietnamese import, registration, inspection, road-use and project-site requirements apply to the final vehicle?
- What is included in the supplier scope: trailer only, drawings, spares, commissioning support, operator guidance or other services?
- Which local party holds responsibility for customs, delivery, approval steps, preventive maintenance and repairs?
These questions show local-market understanding more clearly than a generic claim about “Vietnam demand.” They turn an early opportunity into an engineering, operations and commercial brief that both a local partner and a manufacturer can evaluate.
A Practical RFQ for a Belt-Type Discharge Semi-Trailer
To receive a useful preliminary proposal, provide the cargo type, target volume per trip, expected loaded weight, route, tractor details, unloading video or site drawing, project duration, destination city and required delivery timing. Include the preferred body dimensions only if they are tied to a confirmed operating constraint. If they are not, the supplier should first help identify the configuration questions that need engineering and local verification.
For a project buyer, the objective is not to import the most complex trailer. It is to choose the simplest configuration that can perform the required material cycle with a clear cost, service and compliance plan. A standard tipper may be enough. A belt-type discharge semi-trailer becomes relevant when the unloading workflow—not catalogue size alone—creates a reason to consider it.
FAQ
What is a belt-type discharge semi-trailer?
It is a bulk-material semi-trailer that uses a conveyor-belt discharge concept rather than relying solely on raising the cargo body to unload. The final mechanism and configuration should be confirmed from the actual specification and drawings.
Is a belt-type discharge trailer better than a conventional tipper?
Not in every case. It may be worth evaluating for a defined high-volume, non-tipping unloading workflow. Conventional tipping may remain more appropriate when the site, material, budget and operating cycle support it.
Does the source-sheet price include delivery to Vietnam?
No. The listed figures are EXW reference prices from the supplied comparison sheet. Freight, insurance, customs, tax, inland delivery, approval and local-service costs must be calculated for the actual order.
Can a listed 60 t capacity be used directly for a Vietnam project?
No. The source-sheet number must be verified against the final design, tractor combination, cargo density, gross and axle limits, local approval requirements, route and site conditions.
What should a Vietnam buyer send before requesting a quote?
Send the material description, expected load and trips per day, tractor details, route, unloading-site information, destination market requirements, project timing and preferred support scope.
Discuss the Full Material Cycle Before You Compare Prices
Share your cargo, route, target market, unloading-site conditions and preferred configuration. A tailored discussion can then compare a conventional tipper baseline with a belt-type discharge option, identify the questions that require local verification and prepare a quotation scope that matches the actual project.
Interested in this case?
Contact Us for a Technical Consultation.
