What to verify before specifying a modular deck
Short answer: This Malaysian custom trailer brief combines a removable gooseneck, a detachable modular cargo deck, four axles, a liftable fourth axle and a customer-requested 40-ton winch. The deck can be separated and extended in modules, which was specified to support a more flexible configuration and a freight-saving packing approach. When the fourth axle is raised, its stated maximum ground clearance is 15 cm. These are project-specific requirements, not universal specifications for every RGN trailer. The final deck combinations, winch duty, axle loads, route suitability and shipping savings must be confirmed against the approved drawing and transport plan.

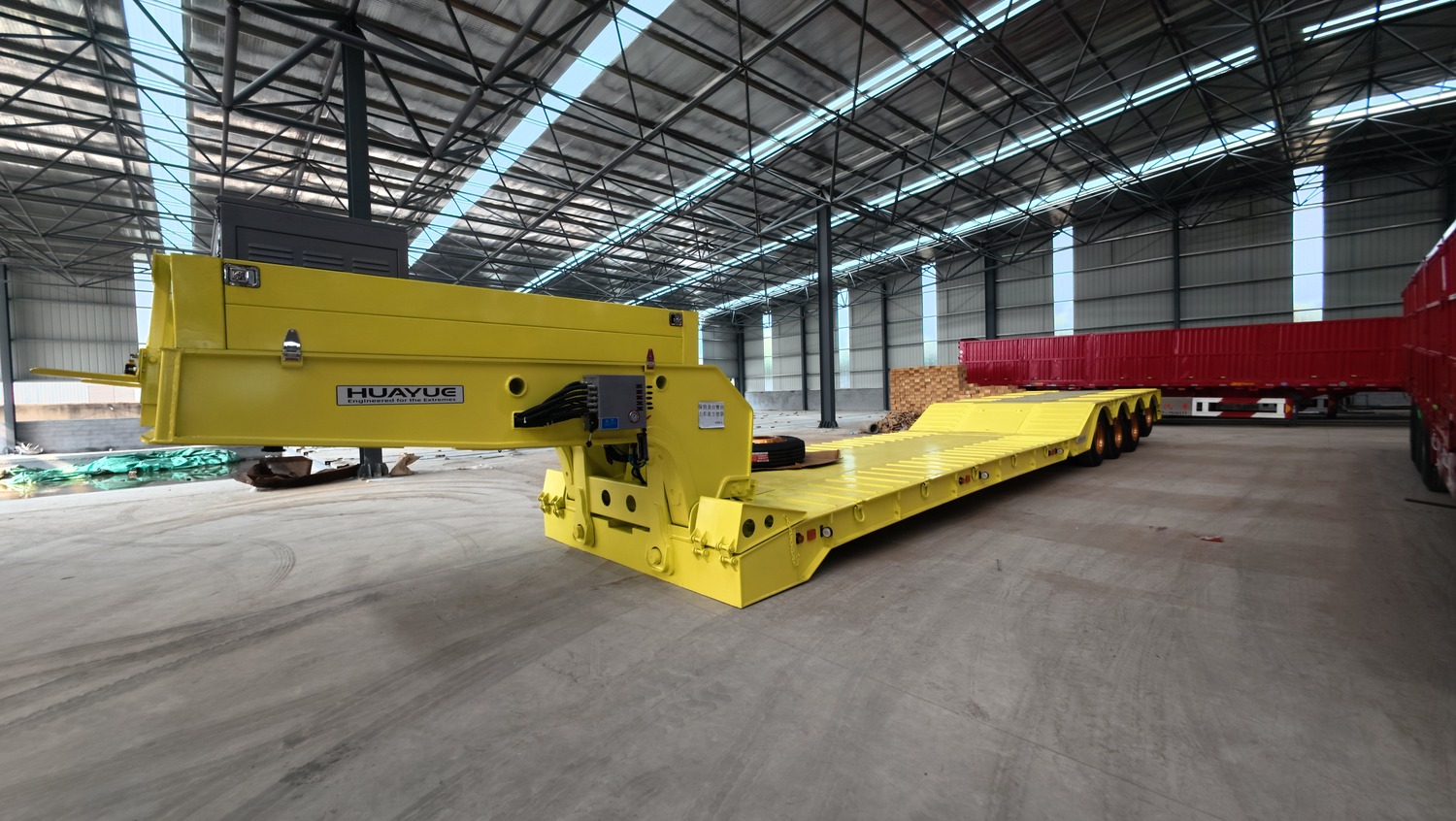

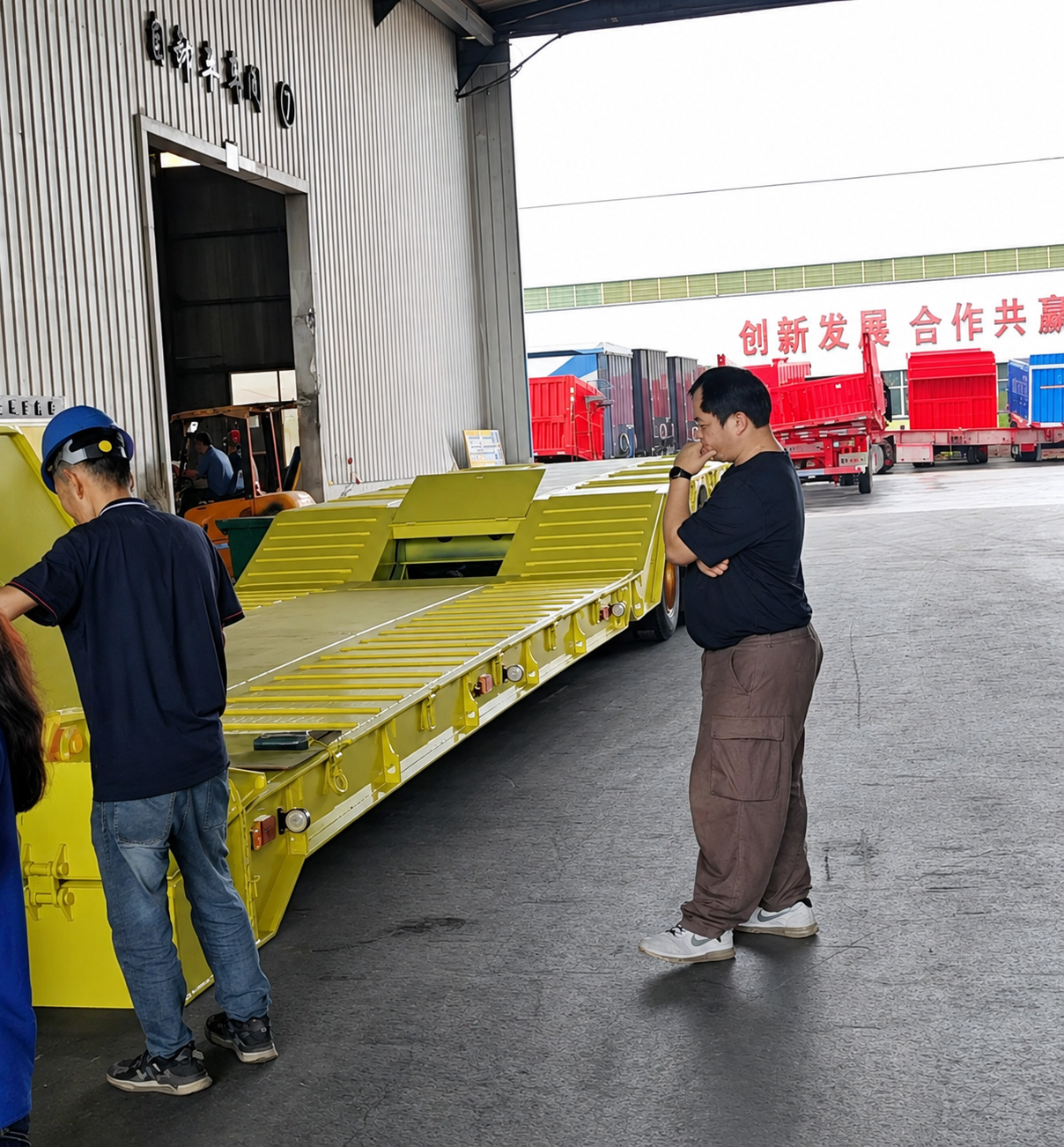

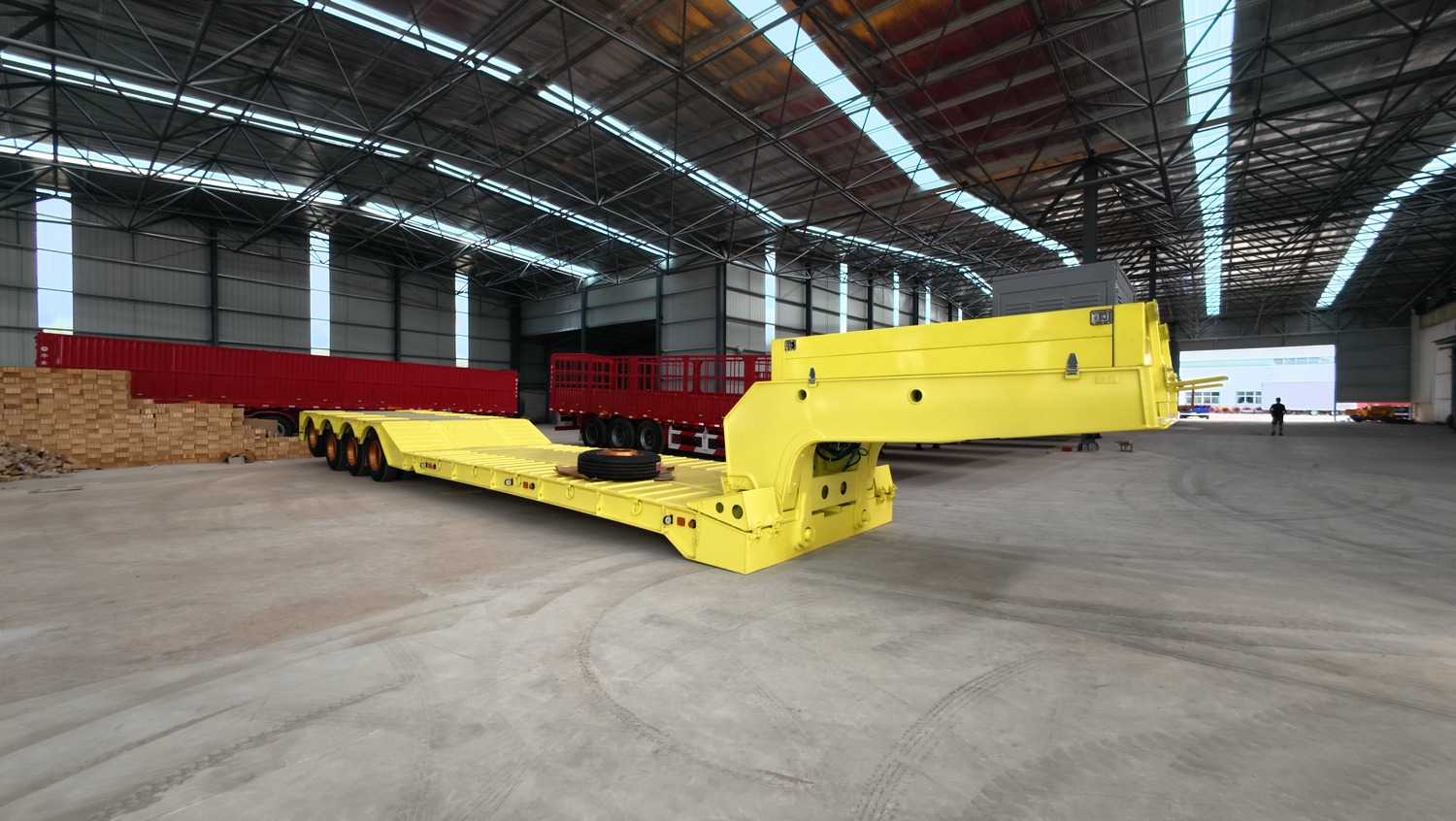

This guide focuses on one purchasing question: how should a buyer evaluate a modular removable-gooseneck trailer when both operating configuration and export packing matter? The photos show the yellow trailer and separate deck/gooseneck sections in a factory environment. They provide visible context for the arrangement, but they do not replace drawings, calculations, inspection records or destination-market approvals.
Why a modular RGN trailer is a different buying decision
A removable gooseneck trailer is not just a deck with a different front section. In this Malaysian brief, the gooseneck, deck layout, winch and axle arrangement are connected decisions. The deck is designed to disconnect into modules and to be extended. That means the procurement team should assess two states: the assembled trailer needed for the intended work and the separated sections needed for shipment or storage.
The customer described the modular deck as a way to realize expansion and save freight. That should be treated as a logistics objective rather than a guaranteed saving. A lower freight bill depends on the actual packaged dimensions, pieces per shipment, mass, container or breakbulk plan, handling requirements, port charges, destination clearance and local delivery plan. A detachable structure only creates a benefit when the confirmed packing plan does so.
For a buyer, the key principle is simple: ask for the operating layout and the export-packing layout together. A proposal that describes only the assembled trailer leaves important commercial questions unanswered.
Visible project configuration
The user-supplied project brief identifies a Malaysian customer and a custom removable-gooseneck configuration. The confirmed brief details are listed below. They should not be expanded into payload, towing, legal-weight or performance claims because no such figures were provided.
| Item | What this project brief supports | What still needs confirmation |
|---|---|---|
| Trailer type | Custom removable gooseneck trailer | Final dimensions, deck height, connection design and operating envelope |
| Deck | Detachable modular cargo deck that can be extended | Approved module combinations, locking method, assembly procedure and load distribution |
| Winch | Customer requested a 40-ton winch | Rating basis, rope layers, duty cycle, power source, controls and safe operating procedure |
| Axles | Four axles; the fourth axle is liftable | Axle ratings, control logic, tyre clearance and permitted operating condition |
| Raised fourth axle | Stated maximum ground clearance of 15 cm when raised | Measurement datum, load state and drawing reference for the stated clearance |
Separating confirmed requirements from open engineering questions helps prevent a frequent procurement error: treating a component rating or a feature description as an overall vehicle capability.

Start with the 40-ton winch requirement
The 40-ton figure in this project belongs to the customer-requested winch. It is not evidence of trailer payload, combination towing capacity or a guaranteed pulling result. Before a purchase order is released, the buyer should obtain a winch data sheet that explains exactly what the rating means.
- Is the stated figure a first-layer line-pull value, a different rating basis or a project convention?
- What rope, drum, fairlead, mounting structure and control arrangement are included?
- What duty cycle and power source apply to the intended operating sequence?
- Which anchoring, recovery and personnel-safety procedures govern use?
- How does the winch interface with the cargo-loading method and the final trailer layout?
These questions are not a claim that a particular operating method is supplied. They are the minimum items a buyer should align with the manufacturer when a winch is part of the requested configuration. The answer should appear in the approved specification, not only in a sales description.
Evaluate the detachable deck as an assembled system

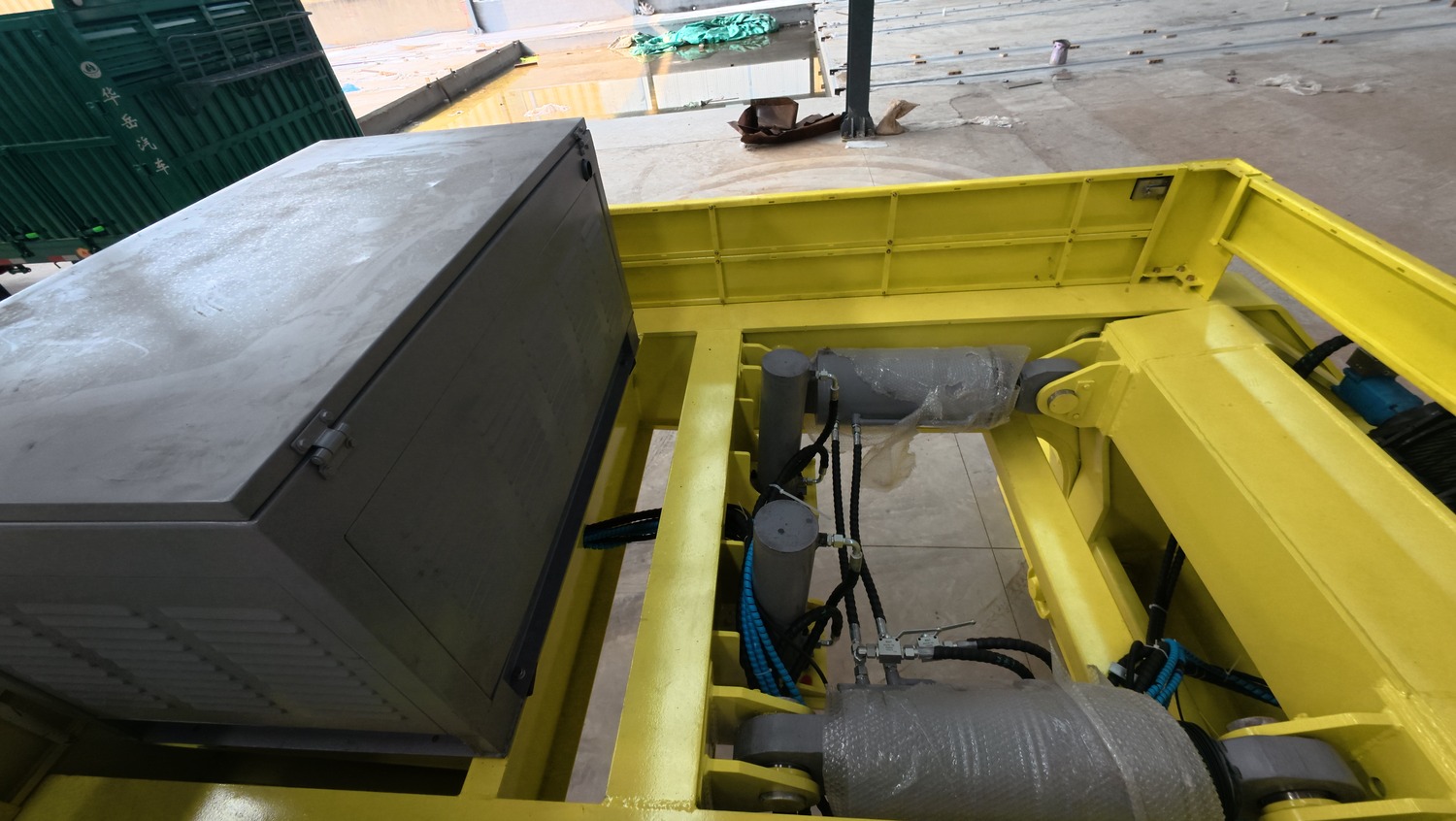

The supplied photos show separated yellow structural sections and connection areas. That visible arrangement is consistent with the project description of a deck that can disconnect into modules. However, images alone do not show the approved assembly sequence, the locking details or the allowable extension combinations.
When a deck is modular, every planned configuration needs its own review. The buyer should ask for a drawing or configuration matrix that shows which modules may be used together, where they connect, how the sections are located and locked, and which inspection points are accessible after assembly. If the deck is extended, the review should also cover overall dimensions, cargo position, centre of gravity, axle distribution, ground clearance and the route plan.
A modular design may be valuable when one project needs one deck arrangement and another needs a different length. It does not mean every combination is automatically appropriate. The supplier should confirm the approved combinations for the actual cargo and operating conditions.

Plan freight savings from the packing drawing, not the concept alone
The Malaysian customer requested a deck concept that could support freight savings. To turn that goal into a commercial decision, ask for a packing drawing before assuming a logistics advantage. It should identify each separated piece, its packed length, width, height and mass, lifting points, protective packing, loading order and the proposed shipping method.
Compare that packing plan with the costs and constraints of shipping the trailer in its assembled condition. The comparison should include freight quotation assumptions, port and terminal handling, special lifting, local transport from port, customs documentation and reassembly requirements. If a savings estimate is offered, request the quotation basis and the date. Freight prices and handling rules can change, and the final amount has not been supplied for this project.
It is equally important to assign responsibility for the transition from packed modules to an assembled vehicle. Confirm who provides assembly instructions, tools, torque or locking checks where applicable, inspection records and acceptance criteria. Do not treat a visual fit-up in a factory photo as proof of an on-site assembly process.
What the liftable fourth axle requires the buyer to verify
This build has four axles, and the fourth axle can be lifted. The stated maximum ground clearance after lifting is 15 cm. That number needs a measurement reference: for example, the condition of the trailer, the tyre state, the suspension position and the exact point from which clearance is measured. Without that reference, the figure should not be used to predict route clearance or operating performance.
The operational decision also requires confirmation of the control method, axle-load distribution, tyre clearance and instructions for when the axle may be raised or lowered. The customer should also verify how the selected deck length, cargo placement and tractor arrangement affect the approved axle configuration. Market-specific registration, mass and axle requirements must be checked for the actual vehicle and route.

RFQ checklist for a modular removable-gooseneck trailer
- Provide cargo dimensions, mass, centre of gravity, loading method and restraint requirements.
- State the required operating deck configuration and every anticipated extension combination.
- Provide the tractor information, fifth-wheel height and available hydraulic or electrical interfaces.
- Request the winch data sheet and define the rating basis rather than using the 40-ton label as a vehicle-capacity figure.
- Request the module connection drawing, parts list, assembly sequence and inspection points.
- Ask for the fourth-axle lift drawing and the measurement reference behind the stated 15 cm maximum raised clearance.
- Obtain an export-packing drawing and freight quotation assumptions before claiming a shipping saving.
- Confirm the destination-market responsibility for registration, permits, inspections, insurance and route approval.
- Agree on the documents delivered with the trailer: drawings, manuals, component data sheets, inspection records and spare-parts scope.
FAQ
Does the 40-ton winch define the trailer payload?
No. In this brief, 40 tons is the customer-requested winch rating. Payload, line pull, towing limits and legal mass limits are different values and must be confirmed separately.
Will a detachable deck always reduce freight cost?
No. The modular deck was requested to support a freight-saving approach, but a saving depends on the final packing plan, freight quote, handling and destination logistics.
Can the deck be extended for any cargo length?
Only for module combinations approved by the supplier. The buyer should confirm structural limits, cargo position, axle distribution, overall dimensions and route requirements for each configuration.
What does the stated 15 cm clearance mean?
It is the stated maximum ground clearance for the raised fourth axle in this project. Confirm the drawing datum and operating condition before using it for route or clearance planning.
Discuss your configuration and packing plan
If you are considering a removable-gooseneck trailer with a modular deck, share your cargo, route, target market, tractor details, preferred deck configuration and shipping plan. Huayue can review the requested configuration and prepare a quotation based on the information that needs to be confirmed for your project.
Interested in this case?
Contact Us for a Technical Consultation.
